Release Notes
Release 8.10 - July, 2025
Highlights
What-If analysis is now part of @RISK
The new What-If Analysis feature—now in the Define group of the @RISK ribbon—replaces TopRank for all DTS licenses. It delivers:
-
Faster performance during scenario testing
-
Richer reporting to identify high-impact inputs
-
Full backward compatibility with existing TopRank models
For more details on how to use this feature you can read: About What-If Analysis
New Predict! Integration: Scale your simulations to strategy
Continue using @RISK in Excel as usual—now with a direct connection to a centralized, governed risk register in Predict!.
Generate CRA models in Predict!, simulate them in @RISK, and send results back to your Predict! folder—all in just a few clicks.
This two-way integration helps you align individual risk analysis into enterprise-wide strategy and reporting.
See how it works:Upload Results to Predict
Enhancements
|
DTS-5628 |
Improve support for newer Windows versions with Unboxed LexFloatServer for Network licenses |
Licensing |
Fixes
|
DTS-5507 |
Palisade Risk ProgressProcess Error when closing @RISK |
@RISK |
|
DTS-5569 |
Cumulative descending percentiles not displayed in @RISK Reports |
@RISK |
|
DTS-5675 |
Optimizer function not working with models with Turkish regional settings |
@RISK |
|
DTS-5607 |
Palisade Server Manager does not install the DTS Service |
Installer / Deployment |
Release 8.9 - January, 2025
Enhancements
|
DTS-5391 |
Add a Restricted Activation Mode for high-security environments with no internet connection |
Licensing |
|
DTS-5249 |
As a DCR user, I’d like to be able to run simulations and fit distributions using DCR8 licenses |
DCR (Previously PCR) |
|
DTS-5252 |
As a DCR user, I’d like to be able to run optimizations using DCR8 licenses |
DCR (Previously PCR) |
|
DTS-5127 |
Upgrade .NET Framework from v4.6.1 to 4.8 |
@RISK / Evolver |
Fixes
|
DTS-5352 |
Additional workbooks created with errors after optimizations with Multi-CPUs |
@RISK |
|
DTS-5385 |
When creating a correlation table between inputs, the name range was wrongly defined |
@RISK |
|
DTS-3001 |
Calculated cost is incorrect for FixedDuration type tasks where WorkContour value is not Flat |
SRA |
|
DTS-5274 |
Project custom fields containing formulas with baseline start or finish dates cause a crash during the import |
SRA |
|
DTS-5291 |
Incorrect duration when importing a Primavera file |
SRA |
|
DTS-5296 |
As Late As Possible constraint is not working as expected when % Compl. >0%, and the task is a successor |
SRA |
|
DTS-5297 |
As Late As Possible constraint is not working as expected with SF Relationships |
SRA |
|
DTS-5299 |
Start Date of tasks with % Complete > 0% are changing when using a Finish No Early Than constraint |
SRA |
|
DTS-5306 |
Incorrect Critical Path when using multiple successors |
SRA |
|
DTS-5321 |
Outputs in summary tasks are replaced by Inputs when copying and pasting tasks - ES Regional Settings |
SRA |
|
DTS-5387 |
Late Start and Late Finish are wrong when a task is 100% completed |
SRA |
|
DTS-5398 |
Start Date of tasks with % Complete > 0% are changing when the task has constraints |
SRA |
Release 8.8.1 - September, 2024
Fixes
|
DTS-5327 |
It is not possible to edit columns to the right in the SRA Model |
SRA |
Release 8.8.0 - September, 2024
Highlights

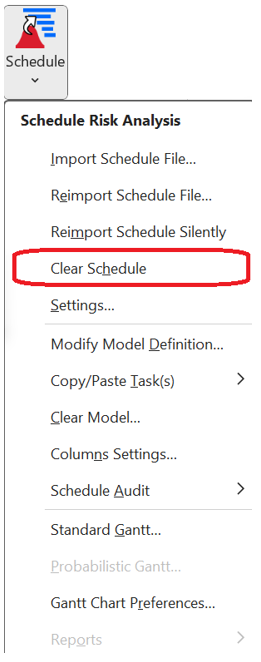

SRA – Replace and Clear SRA Model
These new SRA Clear Schedule and Replace features enable users to create reusable SRA model templates to import different projects.
The Clear Schedule functionality lets users remove all the imported schedule information from the workbook.
The Replace functionality improves the Import Schedule File. With this new version, the user can import a project file to the Active workbook even if it already has a defined SRA Model.
SRA will clear the original model and import the new one in a single action.
For both the Clear and Replace Schedule options, the SRA Model worksheet will keep the SRA Model table headers, user definitions in columns to the right, and additional worksheets the user defines. Users could import any project to this workbook and adapt their Excel definitions to the new project.
Security – XLA files converted to XLAM
@RISK and DTS XLA files were converted to XLAM, a preferred format due to its enhanced compatibility and support for newer Excel features. And most importantly, it provides a more structured, secure, and robust way to manage and distribute Excel add-ins. These are the new files installed with @RISK and DTS: Risk.xlam, RiskSimMultiCpu8.xlam, Ptree.xlam, StatTools.xlam and TopRank.xlam.
Enhancements
|
DTS-4970 |
SRA - Replace and Clear Imported Project |
SRA |
|
DTS-5071 |
Update FlexNet library v11.19.6.0 |
Licensing |
|
DTS-5068 |
Convert XLA to XLAM (Except StatTools Analyses) |
Installer/Security |
|
DTS-5221 |
Add Cryptlex Entitlement ID and LicenseID to the Product Diagnostics Logs |
Licensing |
Fixes
|
DTS-5178 |
Not all tasks with a % Complete higher than zero have simulation results in the Finish Date. |
SRA |
|
DTS-5226 |
The successors column is displaying the Successors Unique ID instead of the ID. |
SRA |
|
DTS-5241 |
@RISK Excel Tool for Evolver not working |
@RISK/Evolver |
|
DTS-5267 |
Tasks with As Late As Possible constraint and 100% Complete wrongly impacting Finished Dates. |
SRA |
|
DTS-5276 |
RiskSplice is not displayed in the Define Distribution Window |
@RISK |
|
DTS-5304 |
Server Manager: Cryptlex service shows as running even if it is busy or the port is already used |
Licensing |
Release 8.7.0 - August, 2024
Highlights
Evolver has been updated with an improved user interface and experience, and up to 4 times faster optimizations.

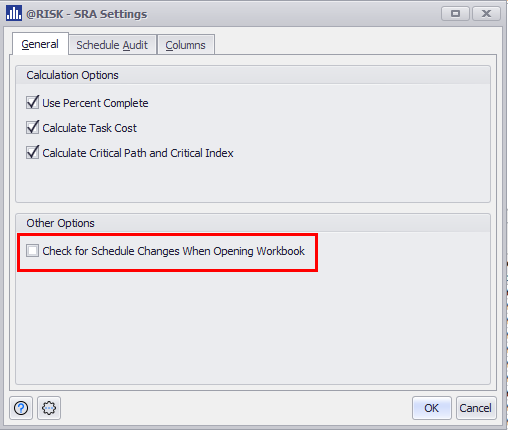

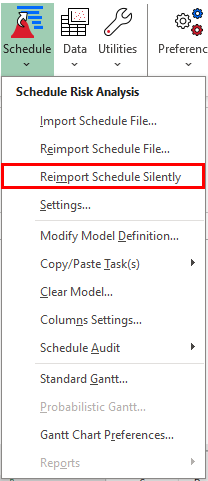

SRA – Silent Reimport
New option to reimport project silently to include any change made to the original project file. Setting to define if reimport is done every time the SRA model is opened.
SRA – Additional column fields
New project fields were added to the Column Setting Option.
MS Project field – Task Summary Name
Primavera P6 fields – Activity ID and Project ID
Enhancements
|
DTS-4759 |
SRA Silent Reimport |
SRA |
|
DTS-4962 |
As a user I want to be able to add Summary Task Name field to my SRA Model Columns |
SRA |
|
DTS-5090 |
As a user I want to be able to add Activity ID and Project ID fields to my SRA Model Columns |
SRA |
Fixes
|
DTS-4185 |
Different simulation results with RiskCompound with multi-CPU simulations with fixed seed for Non-EN Regional Settings (Swiss German, French, Spanish) |
@RISK |
|
DTS-4667 |
Function menu in the @RISK ribbon doesn't display all functions |
@RISK |
|
DTS-4712 |
Browse Window delimiters are not correctly displayed with right-click menu option |
@RISK |
|
DTS-4983 |
Different simulation results for cells with RiskGamma running single-CPU and fixed seed |
@RISK |
|
DTS-5026 |
The tornado graph is not displayed in the @RISK Compact Report when there are more than 12 inputs |
@RISK |
|
DTS-5073 |
@RISK error occurs when editing a Correlation Matrix after a Time Series batch fit |
@RISK |
|
DTS-5093 |
Excel crash when opening @RISK in a virtual environment |
@RISK |
|
DTS-5169 |
Cannot rename worksheet for @RISK models |
@RISK |
|
DTS-5089 |
P6 (XER) file with links to other projects is not correctly imported into SRA |
SRA |
|
DTS-5017 |
After reimporting a project, simulation results were still available from the original project |
SRA |
|
DTS-5025 |
SRA Probabilistic Report error when saving simulation results directly in the workbook |
SRA |
|
DTS-5036 |
The schedule is updated in the Model worksheet despite canceling the reimport |
SRA |
Release 8.6.1 - May, 2024
Fixes
|
DTS-4185 |
Different simulation results with riskcompound() with multi-CPU simulations with fixed seed for Non-EN Regional Settings (Swiss German, French, Spanish) |
@RISK |
|
DTS-4667 |
Function menu in the @RISK ribbon doesn't display all functions |
@RISK |
|
DTS-4983 |
Different simulation results for cells with riskgamma() running single-CPU and fixed seed |
@RISK |
|
DTS-5026 |
The tornado graph is not displayed in the @RISK Compact Report when there are more than 12 inputs |
@RISK |
|
DTS-5017 |
After reimporting a project, simulation results were still available from the original project |
SRA |
|
DTS-5025 |
SRA Probabilistic Report error when saving simulation results directly in the workbook |
SRA |
|
DTS-5036 |
The schedule is updated in the Model worksheet despite canceling the re-import |
SRA |
|
DTS-4454 |
Payoff Calculation Method - VBA Macro is returning errors when using non-code-page character in the file name and model worksheet |
PrecisionTree |
Release 8.6.0 - March, 2024
Highlights
SRA – Simulation supports Multiple Task Calendars
SRA simulation now supports Projects with Multiple Tasks Calendars. When you define multiple Task Calendars in your project and assign them to specific tasks, SRA simulation will now consider their corresponding Working Times to calculate each iteration's Start and End Date.
Using the Column Settings function, you can add the Task Calendar column to your SRA Model and have a reference of the calendar used in each task.
Please review our new example model for SRA – Multiple Task Calendars. You can find it in the @RISK Example Menu > Schedule.
Trial licenses supported by the new Company Licensing System
Lumivero is in the process of phased transition of the @RISK/DecisionTools Suite licenses to a new licensing solution for improved user experience. Your license is described in the License Manager as a "Legacy" license. All legacy licenses belong to the older licensing system; however, they are fully functional, and no action is required from you at this release.
The new Lumivero licensing system now supports all new @RISK/DecisionTools Suite Trial licenses.
Enhancements
|
DTS-4416 |
SRA – Simulation supports Multiple Task Calendars |
SRA |
|
DTS-4088 |
Remove Microsoft's Microsoft Foundation Classes (MFC) dependencies |
@RISK |
|
DTS-4316 |
Trial licenses supported by a new Company Licensing System |
Licensing |
Fixes
|
DTS-4307 |
The Start Date of the Project Summary Task does not change when using delays |
SRA |
|
DTS-4374 |
#REF! error after removing all @RISK functions from the SRA Model with Critical Path column before the inputs and outputs columns |
SRA |
|
DTS-4703 |
Multiple As Late As Possible Constraints are not working correctly |
SRA |
|
DTS-4384 |
Gantt chart export preview is updated each time a custom date control loses its focus |
SRA |
|
DTS-4457 |
Unable to draw graph in Distribution Artist |
@RISK |
|
DTS-4801 |
Unable to install @RISK because of Registry Key security policy limitations in Windows Enterprise |
Installer |
|
DTS-4830 |
InstallShield CVE-2021-41526 Vulnerability within @RISK |
Installer |
Release 8.5.2 - October, 2023
Enhancements
|
DTS-4446 |
Convert NeuralTools.XLA to NeuralTools.XLAM for better Antivirus support |
NeuralTools |
|
DTS-4607 |
New Lumivero's Master License and Service Agreement |
Licensing |
Fixes
|
DTS-4457 |
Unable to draw graph in Distribution Artist |
@RISK |
|
DTS-4374 |
#REF! error after removing all @RISK functions from SRA Model with Critical Path column before the inputs and outputs columns |
SRA |
|
DTS-4453 |
Files are not removed from Palisade/System folder during uninstall |
Installer |
Release 8.5.0 - July, 2023
Highlights

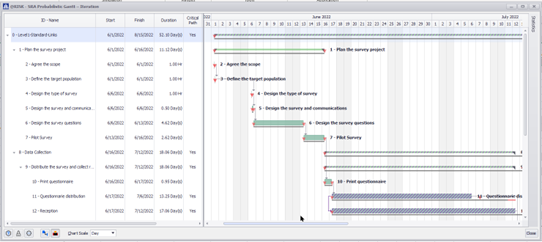

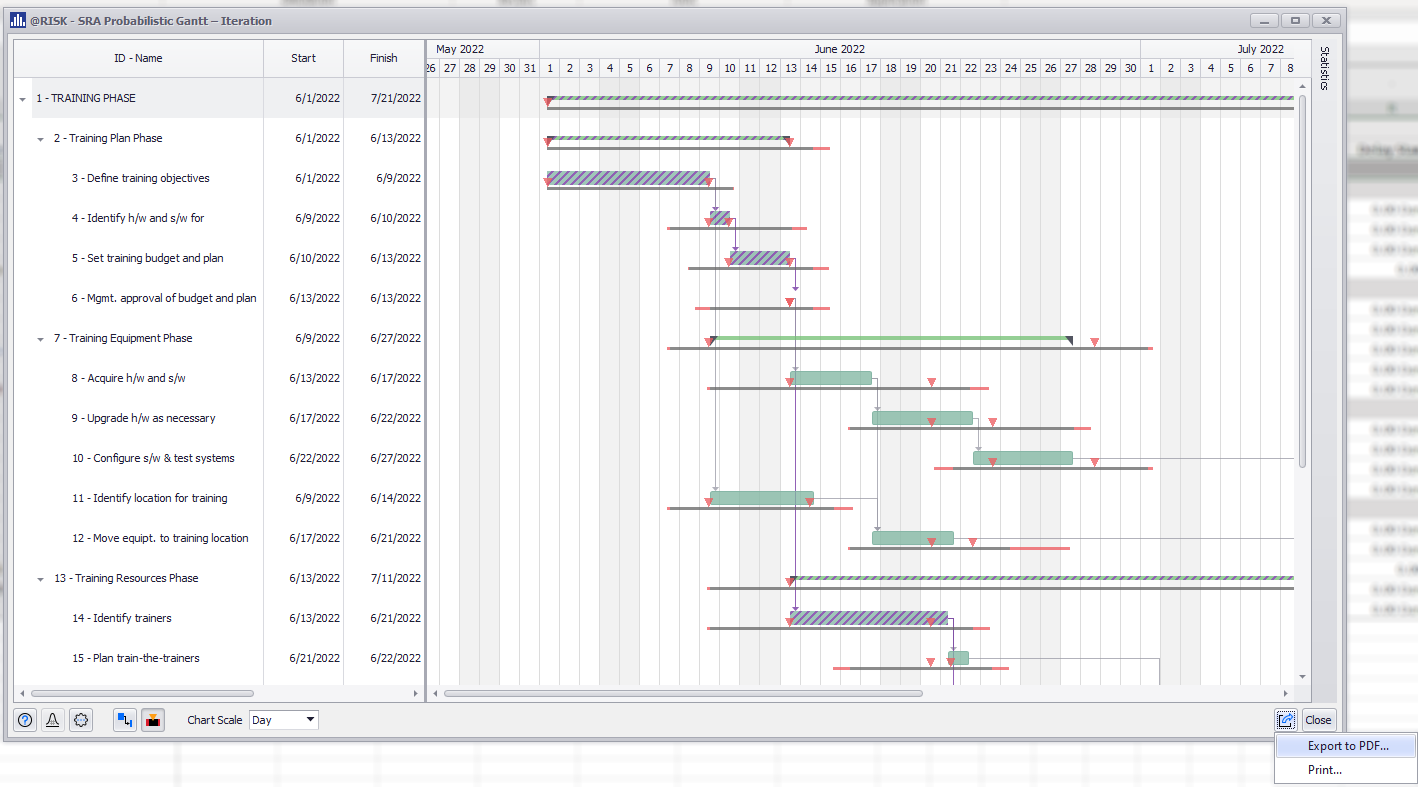

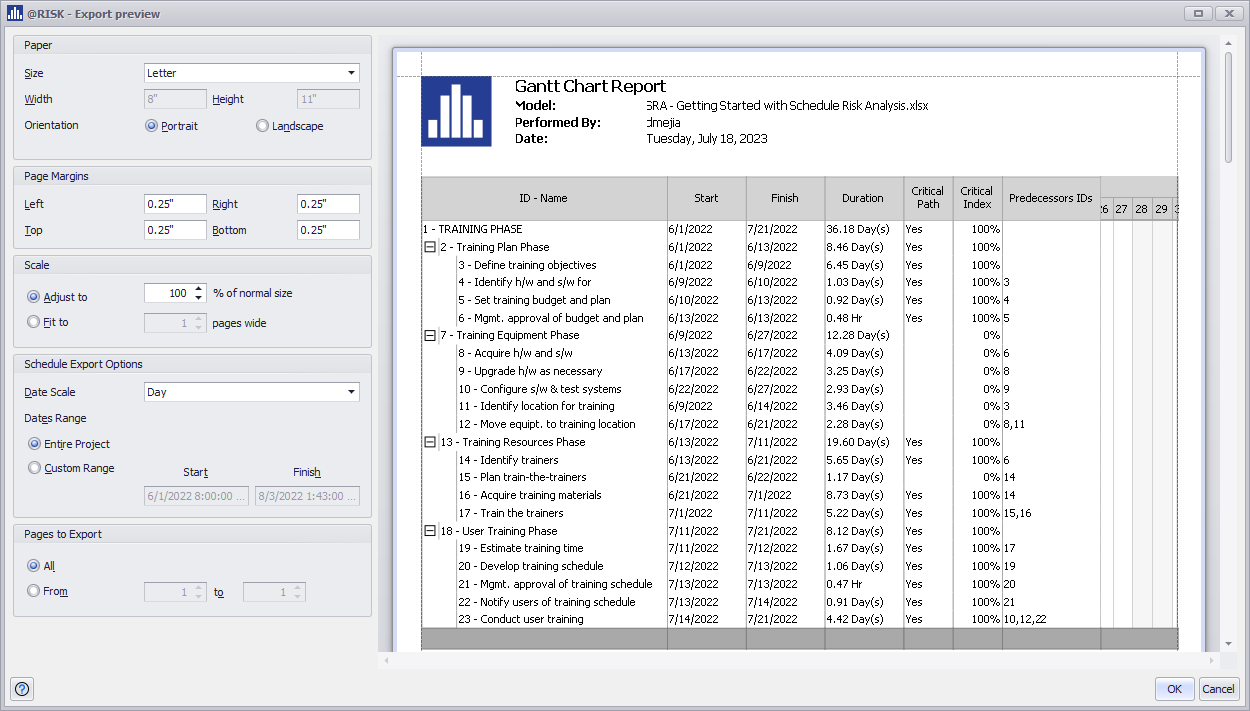

SRA: Export and Print Gantt Charts

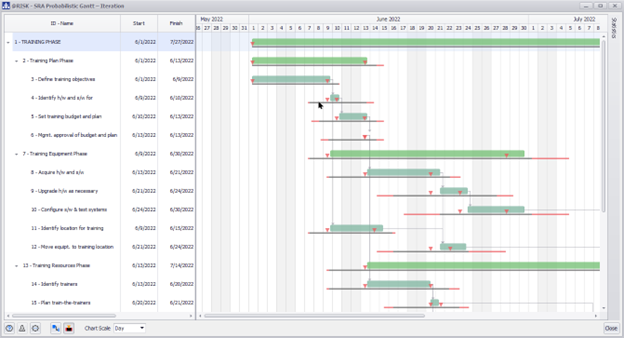

This new feature to export to PDF and print SRA Gantt Charts enables customization of Standard and Probabilistic Gantt Chart exports, including project dates, scales, and industry standards like paper sizes, page margins, orientation, and scale.
Synchronize time series at any point of historical data.

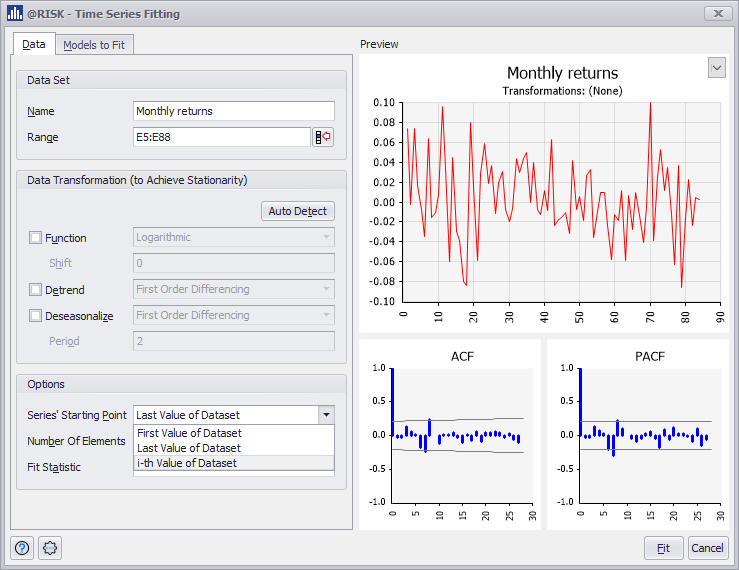

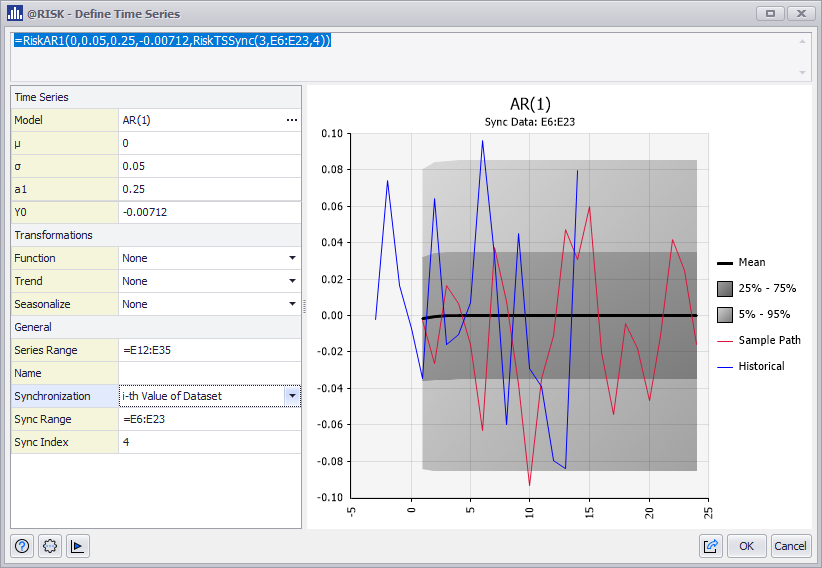

The Time Series Synchronization function now supports synchronizing forecasts to Define and Fit Time Series at any historical data point.

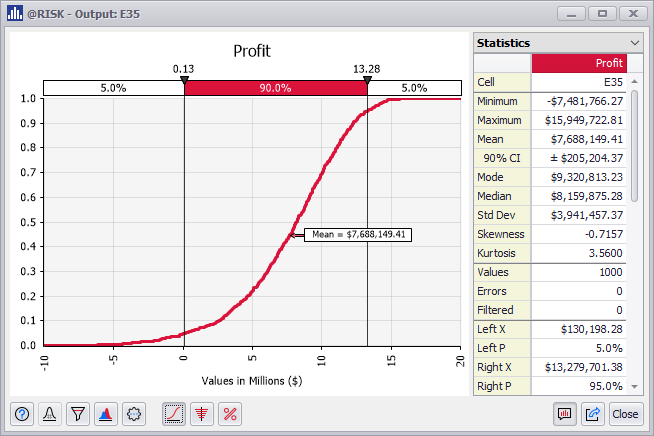

Display horizontal markers next to the curve in Cumulative Distribution Graphs.
New, improved visualization for Markers in Cumulative Distribution Curves. For graphs with a single cumulative curve, markers are now horizontal by default, pointing precisely to the selected value.
Enhancements
|
DTS-3929 |
SRA - New feature to Export and Print Deterministic and Probabilistic Gantt Charts |
SRA |
|
DTS-654 |
New option to synchronize Time Series Definition and Fitting at any point of historical data |
@RISK |
|
DTS-1034 |
Display horizontal markers next to Cumulative Distribution curves |
@RISK |
|
DTS-929 |
RiskResultsGraph now supports @RISK models cells that are neither inputs nor outputs |
@RISK |
Fixes
|
DTS-4309 |
List to select Duration Distributions in SRA Model Worksheet not working with Non-English Regional Settings |
SRA |
|
DTS-4353 |
@RISK crashes when importing a P6 project with out-of-sequence tasks |
SRA |
Release 8.4.1 - June, 2023
Enhancements
|
DTS-4296 |
Update Aspose.Tasks to .NET 23.5 |
SRA |
Fixes
|
DTS-4263 |
Unable to import P6 Project into SRA because of TimeSpan error |
SRA |
|
DTS-4297 |
SRA Model is not recalculating when switching to Static mode |
SRA |
|
DTS-4216 |
@RISK ribbon loses focus when a second SRA project is imported |
SRA |
|
DTS-4235 |
Error message when changing graphing preferences |
@RISK |
|
DTS-4218 |
#VALUE! error when creating a Tree from an Influence Diagram with English Regional Settings |
PrecisionTree |
Release 8.4.0 - April, 2023
Highlights

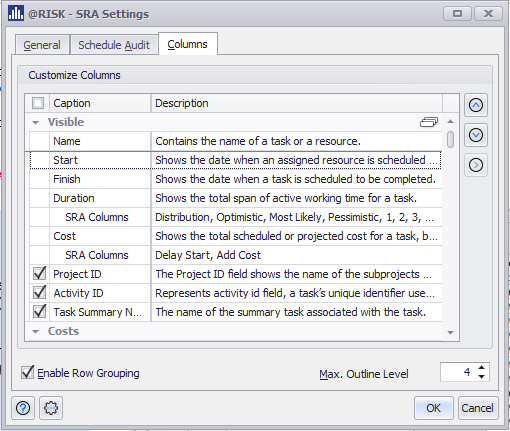

SRA: Add more Project field columns in the Model worksheet.
New feature to include additional MS Project or Primavera project fields to the Model worksheet as reference columns. Fields can be selected and arranged in the Columns tab of the SRA Settings dialog.
SRA: Group columns and rows in the SRA Model

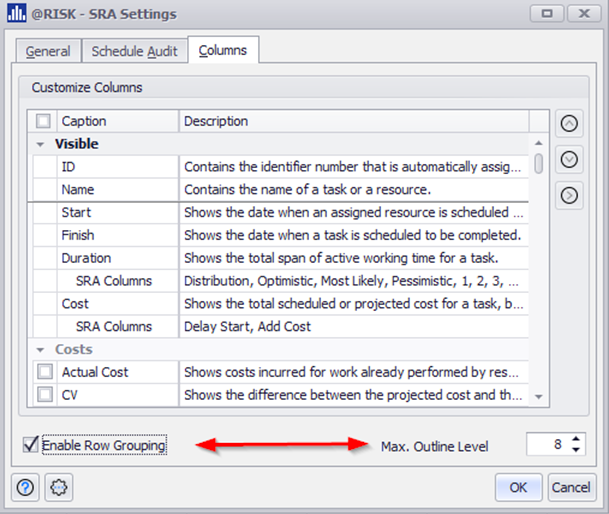

The Column Settings tab also has two new options to group Model rows and columns:
-
Select one or more additional columns to group them as part of an existent group or with the previous column in the Columns Settings Tab.
-
Easily group Model Worksheet rows up to eight levels of task's Outline level.

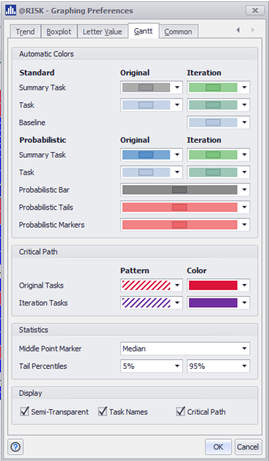

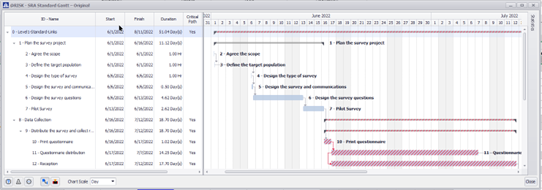

SRA: Visualize Critical Path in Gantt Charts
Original and Iteration Critical Path Tasks are now formatted in the Standard and Probabilistic Gantt Chart Views.
Customize the format in the Graphing Preferences for all models and Chart Options for the specific model Gantts.

SRA: Inactive tasks considered in the project schedule simulation
SRA schedule simulation was improved to consider inactive tasks previously defined in MS Project or Primavera. Inactive tasks now have a different format in the Model Worksheet, Gantt Chart, and SRA Reports.
Enhancements
|
DTS-3113 |
Support long simulation names in Summary Trend Graphs for Multiple Simulations |
@RISK |
|
DTS-3955 |
New option to group Outputs by Default Ranges in the Model List and Results Summary |
@RISK |
|
DTS-3957 |
New option to remove one or more cells from an Output Range |
@RISK |
|
DTS-3880 |
Updated OptQuest version |
Risk Optimizer |
|
DTS-927 |
Support Optimizations for protected sheets with password |
Risk Optimizer |
|
DTS-3693 |

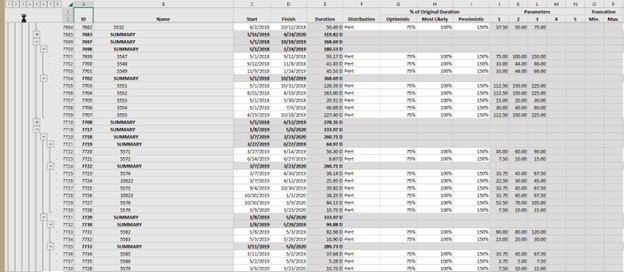

New option to add more Project field columns in the Model worksheet |
SRA |
|
DTS-4073 |
Warning about Critical Path and Cost Calculation Settings before Simulation starts |
SRA |
|
DTS-3797 |

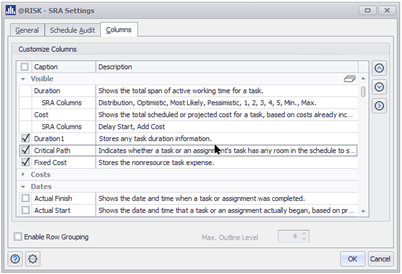

New SRA Settings dialog |
SRA |
|
DTS-3922 |

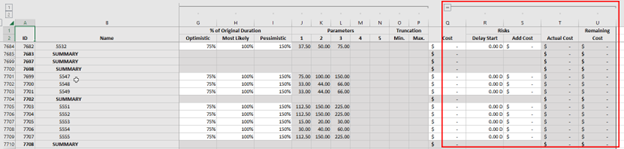

Additional project fields displayed in the Reimport Change Log |
SRA |
|

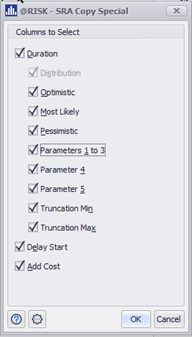

DTS-3893 |
New Copy Special feature to Copy-Paste model definitions across locked cells |
SRA |
|
DTS-3937 |
Visualize Original and Iteration Critical Path Tasks in the Standard and Probabilistic Gantt Chart Views |
SRA |
|
DTS-3934 |

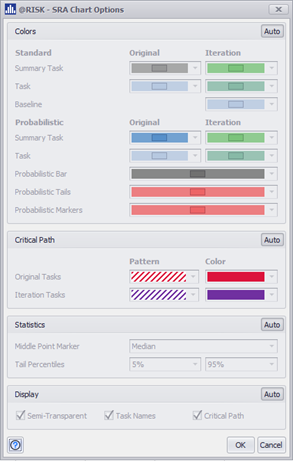

Customize Options and Preferences for Critical Path format |
SRA |
|
DTS-4005 |
Inactive tasks considered in the schedule simulation |
SRA |
|
DTS-4006 |
Formatting Inactive Task in Model Worksheet and Gantt Charts |
SRA |
|
DTS-3966 |
Early and Late Dates and Critical Path fields now can be defined as Outputs when displayed in the Model Worksheet |
SRA |
|
DTS-4049 |

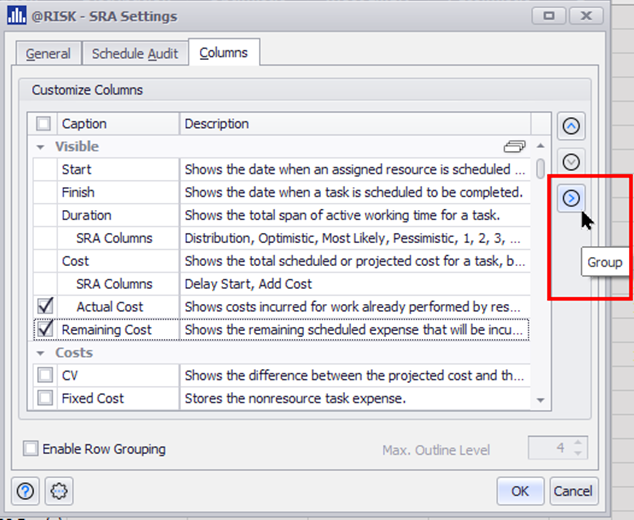

New option to group columns and rows in the SRA Model |
SRA |
|
DTS-4002 |
New format for Summary Tasks in the Gantt chart window |
SRA |
|
DTS-3858 |
Copy Statistics Data from the selected task in Gantt Charts |
SRA |
|
DTS-3661 |
Optimized processes to create Chart-in-Excel |
@RISK |
|
DTS-3878 |
Disable the AddMulti method in StatTools XDK |
StatTools |
|
DTS-2900 |
Local Help deprecated from @RISK and Evolver |
Documentation, @RISK, Evolver |
Fixes
|
DTS-1559 |
Some numbers are stored as text when Input Reports are written in Excel |
@RISK |
|
DTS-2980 |
Browse Results doesn't update to another cell during simulation |
@RISK |
|
DTS-3205 |
Delayed recalculation or duplicated recalculation in the iteration step mode |
@RISK |
|
DTS-3370 |
Exception when Browse Results window is restored during simulation start |
@RISK |
|
DTS-3581 |
Linked-fitted distribution does not include RiskFit when written over another distribution |
@RISK |
|
DTS-3831 |
Graphing Options Axis Scale does not allow to enter percentage values |
@RISK |
|
DTS-3857 |
Bad list separator in RiskOptimizer Constraint Definition dialog with Spanish regional settings |
@RISK |
|
DTS-2367 |
Results Summary window is not shown during the optimization process |
@RISK |
|
DTS-3785 |
RiskOptimizer - Incorrect format in the Result Column of Log reports |
@RISK |
|
DTS-3887 |
XDK optimization example gives Compile error |
@RISK |
|
DTS-2702 |
Cannot launch DTS Tools from the desktop icon when you launch @RISK as an administrator |
@RISK |
|
DTS-3286 |
Run time error displayed in @RISK upon uninstalling Server Manager |
@RISK, Server Manager |
|
DTS-3945 |
Silent installation doesn't install @RISK in Spanish |
@RISK, Installer |
|
DTS-3841 |
PrecisionTree and @RISK options are not working as expected in Step Mode |
Precision Tree |
Release 8.3.3 - February, 2023
Fixes
| DTS-3895 | Wrong Values in X-axis for Regression Mapped Tornados for SRA Outputs with Date format | @RISK - SRA |
| DTS-3923 | RISKOptimizer "Performing end-of-optimization tasks..." message missing | @RISK |
| DTS-3956 | Simulation failed because the workbook name has a single quote and was not allowed | @RISK |
| DTS-3869 | It is not possible to select Extended Trial licenses from @RISK License Manager | Licensing @RISK |
Release 8.3.2 - November, 2022
Highlights
@RISK: ScheduleRiskAnalysis

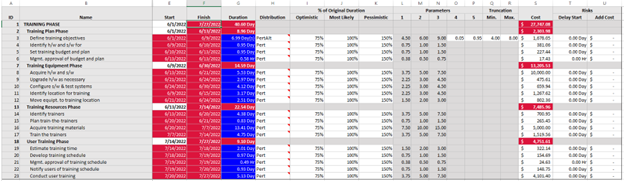

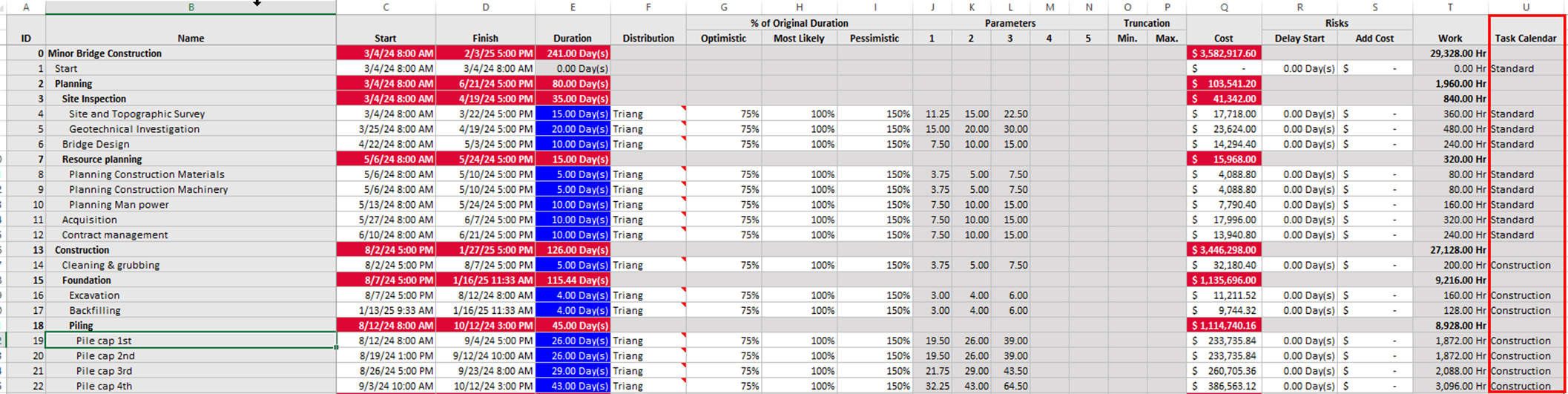

The new @RISK ScheduleRiskAnalysis allows you to define schedule risk models in Excel for project files created in Primavera P6 or Microsoft Project, by applying all the power and flexibility of @RISK Monte Carlo simulation.
-
Import and reimport project files to Excel
-
Add inputs to tasks durations and outputs to project fields you want to analyze
-
Link tasks to risk events to add delays and costs.
-
Analyze Schedule Risk Results with Standard and Probabilistic Gantt Charts
@RISK: New RISKOptimizer User Interface
The @RISK RISKOptimizer feature has been updated with an improved user interface and experience, and faster optimizations with 64-bit Excel.
@RISK: New Stress Analysis User Interface
The @RISK Stress Analysis feature has been updated with an improved user interface and experience.
Evolver: New Online Documentation

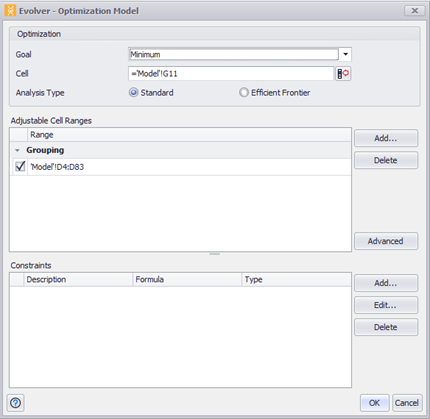

Evolver documentation is now online. All Evolver dialogs will now access the corresponding online page.
Please Note: Spanish documentation was partially completed as of the release date. The product will automatically start delivering Spanish documentation content as soon as it becomes available online.
Enhancements
| DTS-482 | New RISKOptimizer User Interface | @RISK |
| New Stress Analysis User Interface | @RISK | |
| DTS-2170 | Support running simulations with @RISK models with correlation matrix and protected workbooks | @RISK |
| DTS-2393 | New Read-Only mode for the Define Distribution Window allows visualizing distribution graphs, statistics, and parameters when the source cell is protected | @RISK |
| DTS-3477 | New ScheduleRiskAnalysis for @RISK | @RISK |
| DTS-2580 | Evolver Online Help Documentation | Evolver |
| DTS-2546 | Support TopRank models with correlation matrix and protected workbooks | TopRank |
Fixes
| DTS-1983 | Incorrect graph when RiskLock is on a Frequency Distribution for RiskCompound | @RISK |
| DTS-2168 | Unable to create a template report from a protected workbook | @RISK |
| DTS-2169 | Error message when exporting a chart in Excel from a protected workbook | @RISK |
| DTS-2240 | Excel crashes when creating Advanced Sensitivity Analysis Reports when tracking the Standard Deviation | @RISK |
| DTS-2385 | Export report for Data Window has columns mixed between worksheets inputs/outputs | @RISK |
| DTS-2595 | Lognormalt with RiskTruncate2 is giving an error | @RISK |
| DTS-2600 | Improved Error Message when running a Solver model with unknown errors and @RISK | @RISK |
| DTS-2608 | Simulation won't run if a column name in a table starts with the @ character | @RISK |
| DTS-2785 | Cannot open Distribution Artist when active cell is a date | @RISK |
| DTS-2879 | Browse results window only shows one output graph regardless of which output is selected | @RISK |
| DTS-3186 | Fitting Discrete Sample Data: Error Message when scrolling down Statistical Summary | @RISK |
| DTS-3199 | Enable correct available ranking methods in the Fitting dialog for Discrete Sample Data | @RISK |
| DTS-3617 | Advanced Sensitivity Analysis Input Graphs are empty when Output and Input are Dates | @RISK |
| DTS-3641 | Scatter Plots are not shown in the Define Copula Window with Spanish Regional Settings | @RISK |
| DTS-3181 | Suspicious Binary Detected by Antivirus is now whitelisted | DTS |
| DTS-2871 | Evolver progress window doesn't go away after canceling optimization | Evolver |
| DTS-3028 | Hypothesis Test for Mean/Std. Deviation with Paired-Sample Analysis and Summary Statistics as Input Data returns Runtime Error | StatTools |
| DTS-2551 | Error when opening files with Macros and Concurrent Licenses | Licensing @RISK |
Release 8.2.2 - March, 2022
Fixes
| DTS-2784 | Unable to visualize the Probability Density graph for Burr12 due to X-Axis scaling | @RISK |
| DTS-2795 | Error message when adding an output to cells with Excel Names starting with the word "True" | @RISK |
| DTS-2604 | Unable to select network licenses when there are two license servers running | Licensing |
| DTS-2633 | Unable to select network licenses because the server is not replying to client messages | Licensing |
Release 8.2.1 - December, 2021
Highlights
@RISK: Time Series Fitting Increased Range Limits
The number of data points that can be used in Time Series Fitting has been significantly increased; longer time series data - up to a million data points - can now be used effectively, though the fitting process may still take significantly longer with larger data sets.
Additionally, the historical graph in Time Series graphs will only display 2000 data points, no matter how large a data series is used.
Please note: @RISK will no longer try to prevent Time Series Fitting with any data series, but larger data sets may cause "out of memory" errors and other unexpected behavior.
Enhancements
| DTS-2433 | Time Series Fitting Increased Range Limits | @RISK |
Fixes
| DTS-2105 | Hidden Sheet data overwrites existing model worksheet | @RISK |
| DTS-2184 | Negative Values for the omega parameter of an EGARCH model return errors | @RISK |
| DTS-2248 | Creating reports with tracking statistic of Standard Deviation crashes Excel | @RISK |
| DTS-2273 | @RISK crashes when defining new Time Series with transformations | @RISK |
| DTS-2330 | Browse Results Window does not display graph after changing number of simulations | @RISK |
| DTS-2354 | Model List closes when trying to open Define Distribution Window when a function includes incorrect arguments | @RISK |
| DTS-2379 | Valid Time Series fit returns #VALUE! error when writing to Excel | @RISK |
| DTS-2413 | Input names in Tornado graphs don't display when RiskName references Excel Table Headers | @RISK |
| DTS-2416 | Chinese characters in workbook name prevent multiple CPU simulations from running | @RISK |
| DTS-2577 | Running multiple CPU simulations causes exception errors | @RISK |
| DTS-2583 | Input Report Setup does not update group option when a Time Series Report is selected | @RISK |
| DTS-2603 | Detailed Statistics Report is generated even when no simulation data exists | @RISK |
| DTS-2609 | Opening a swapped-out file closes Excel | @RISK |
| DTS-2182 | Data Viewer - Chart in Excel option does not work | NeuralTools, StatTools |
Release 8.2 - July, 2021
Highlights
@RISK: Dynamic Array Functions
Six new @RISK formulas allow you to create Excel dynamic arrays with @RISK simulation data, results are returned in a dynamic array of whatever size is necessary to hold the values:
- RiskDataDA: returns the simulated data value(s) of simulation.
- RiskSensitivityDA: returns the sensitivity analysis information of simulated output.
- RiskSensitivityStatChangeDA: returns the “change in output statistic” sensitivity analysis information of the simulated output.
- RiskFitParametersDA: returns the values for the parameters of the best fitting distribution from the fit performed by the RiskFitDistribution.
- RiskFitStatisticsDA: returns the statistics from the fit performed by the RiskFitDistribution.
- RiskCorrectCorrmatDA: returns a corrected correlation matrix.
- RiskSimulationInfoDA: returns all simulation information options in one dynamic array.
This functionality only works on Office 365 with Excel Dynamic arrays.
See these online examples to see how @RISKDataDA and @RISKSensitivityDA can be used to create dynamic Excel Charts:
Dynamic Arrays - RiskDataDA with an LDA Base Model
Dynamic Arrays - RiskSensitivityDA with a New Product Development Base Model
@RISK: Error Handling with Debugging Messaging
There is a new Error handling functionality that will identify misconfigured or incorrect @RISK elements, including distribution functions, outputs, and @RISK statistic functions.
This release includes the following Error Handling:
Distribution Functions error warnings and explanations are included in the Define Distribution, Model List, and the Results Summary Windows and can be seen by hovering over the icon.
Figure 1 - Distribution Function Error Warning
All @RISK functions with error warnings can be filtered in the Model List and the Results Summary Windows using the new Issue View button (
).
Details of the error from a cell with a Distribution Function can be viewed in the Excel status bar at the bottom of the Excel window.
Output and Statistical Function errors resulting from their precedent distribution functions with errors are included in the Results Summary Windows and can be seen by hovering over the icon.
@RISK: Added Letter Value Graphs
The Letter Value graph is a new Summary Graph that takes a Box Plot Graph to the next level! It graphs the spread with a variable number of letter value boxes. You will be able to visualize better estimates further out into the tails and reduced number of “outliers” displayed for large data sets.
Figure 2 - Summary Letter Value Graph
See this online example to see how this new graph is used in a Operational Risk model:
Letter Value Graph - Letter Value Graph with an LDA Base Model
@RISK: Select from Multiple Sheets When Creating Scatter Plots
The dialog to create Scatter Plot Graphs has been updated to allow selecting inputs and outputs from multiple worksheets.
Figure 3 - Scatter Plot - Select Axis Window
@RISK: Swap Overlayed Distributions

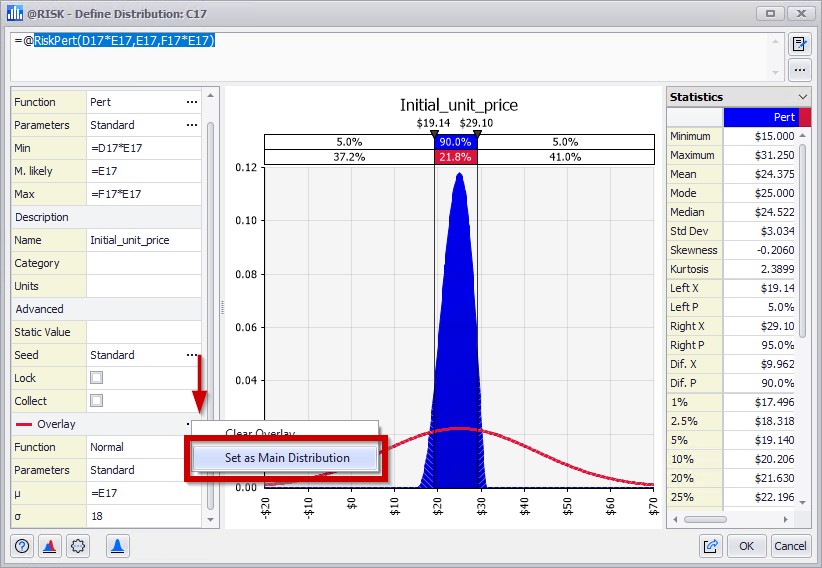

The Define Distribution window now allows for swapping overlay distributions with the original distribution, replacing the original @RISK function with the overlay's @RISK function. This enables quick comparison of input definitions and quick selection of the distribution that is most appropriate to the model.
Figure 4 - Define Distribution - Swap Overlay
@RISK: Export Simulation Data from Graph Windows
The Browse Results, Scatter Plot, and Summary Graphs Windows now have the option to Export or Copy the Simulation Data for the displayed inputs or outputs.

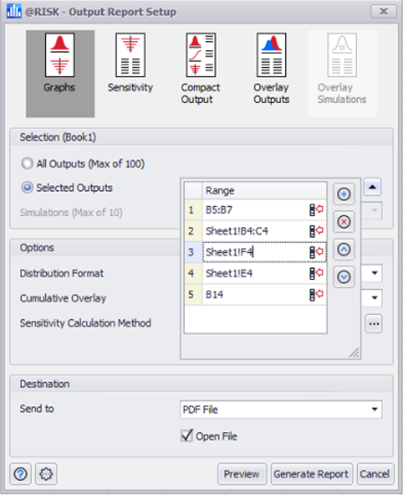

@RISK: Simulation Data Report
The new Simulation Data Report now allows for the selection of inputs and/or outputs to generate a report with their Simulation Data in an Excel Worksheet.
@RISK: Input/Output Thumbnails in Data Window
Thumbnail graphs for inputs and outpus are now included in the Data Window, aiding in the interpretation of simulation results.
@RISK: Sampling Type and Generator Added to RiskSimulationInfo
Two new arguments have been added to the @RISK function RiskSimulationInfo; these will display the Sampling Type and Generator used during the simulation.
@RISK: New Advanced Sensitivity Analysis User Interface
The @RISK Advanced Sensitivity Analysis feature has been updated with an improved user interface and experience.
@RISK: New License Manager User Interface
The @RISK License Manager feature has been updated with an improved user interface and experience.
@RISK: New Software Update User Interface
The @RISK Software Update feature has been updated with an improved user interface and experience.
NeuralTools: Updated Warnings
Now when testing or predicting PN/GRN nets there are also warnings for the number of test and prediction cases whose values are not between the minimum and maximum of the corresponding training variables. These warnings can be found in the Preview dialogs, Reports and as a note in the Live Prediction cell for numeric independent variables.
Enhancements
| DTS-1675 | SmartSensitivity Analysis works with Excel LAMBDA functions | DecisionTools Suite |
| DTS-303 | Letter Value Graph added to Summary Graphs group and views | @RISK |
| DTS-392 | Error handling with useful debugging information across the user interface | @RISK |
| DTS-402 | @RISK Dynamic Array Functions | @RISK |
| DTS-483 | New License Manager User Interface | @RISK |
| DTS-485 | New Software Update User Interface | @RISK |
| DTS-644 | Sampling Type and Generator added to RiskSimulationInfo | @RISK |
| DTS-1009 | Export Simulation Data from Graph Windows | @RISK |
| DTS-1032 | Select one of the overlayed distributions to replace the original one | @RISK |
| DTS-1236 | Select inputs/outputs from multiple sheets when creating a Scatter Plot | @RISK |
| DTS-1240 | New Advanced Sensitivity Analysis User Interface | @RISK |
| DTS-1320 | Simulation Data Report | @RISK |
| DTS-374 | Warnings for cases outside the range of training data | NeuralTools |
Fixes
| DTS-124 | Registry Key is inaccessible if the first run of the product after install is under an Admin Account but subsequent runs are not | @RISK |
| DTS-1470 | RiskSimulationInfo function is showing #N/A when opening a file with simulation data saved in it | @RISK |
| DTS-1628 | Macro file in XLSTART directory prevents multiple CPUs from being used | @RISK |
| DTS-1747 | Adding RiskVary overlay in Define Distribution window doesn't make use of parameters of underlying distribution | @RISK |
| DTS-1799 | RISKOptimizer models with correlations matrices can cause Excel to crash when running with multiple CPU | @RISK |
| DTS-1957 | RiskCumul showing different results for Standard Deviation between @RISK versions | @RISK |
| DTS-1970 | Models with linked fits crashed on Windows 7 | @RISK |
| DTS-1988 | Saving an @RISK model workbook is not possible after deleting some columns with distributions functions | @RISK |
| DTS-2035 | Excel crashes with multiple CPU simulations | @RISK |
| DTS-2110 | Error when generating a Sensitivity Scatters Report in active workbook | @RISK |
| DTS-2113 | The XDK CreateScenarioReport method crashes Excel | @RISK |
| DTS-1369 | Cancelling prompt during uninstall doesn't stop the process if there's a borrowed license | Installer |
| DTS-1704 | Repair option is not working Server Manager | Licensing |
| DTS-1763 | Add missing Spanish example files so they can be accessed from the Examples worksheet | NeuralTools |
| DTS-1832 | Validation error on a non-active tab in Model Settings Dialog doesn't change tab to highlight error | PrecisionTree |
| DTS-1992 | Error message when defining input ranges in Sensitivity Analysis | PrecisionTree |
| DTS-1715 | TopRank analysis may crash if @RISK also loaded and displaying Browse Results Window | TopRank |
Release 8.1.1 - March, 2021
Enhancements
| DTS-301 | Installation now requires EULA approval | Installer |
| DTS-501 | Updated licensing components to use FlexNet version 11.18 | Installer |
| DTS-877 | StatTools and TopRank Spanish local documentation now available | Documentation |
Fixes
| DTS-1760 | Addin Launcher sometimes gets stuck at "Initializing Microsoft Excel..." | DecisionTools Suite |
| DTS-1381 | Dynamic Arrays compatibility problem when running a simulation with linked fit | @RISK |
| DTS-1478 | Filter definitions cleared after disabling All Filters and running a simulation | @RISK |
| DTS-1512 | Uncolored Tornado bar when baseline value is not within the bar values | @RISK |
| DTS-1531 | Progress Window incorrectly shows Multiple CPU recommendation when running a Goal Seek simulation | @RISK |
| DTS-1547 | Clear Filter option in the Single Filter dialog not working properly | @RISK |
| DTS-1553 | Define Distribution Window graph customization not saved properly | @RISK |
| DTS-1604 | Goal Seek can experience poor performance during simulation start | @RISK |
| DTS-1631 | Error in Define Correlation Matrix when active cell contains special characters | @RISK |
| DTS-1707 | Graph customization lost when Excel file loaded before @RISK is started | @RISK |
| DTS-1741 | Distribution fits with input data filters not working correctly in all cases | @RISK |
| DTS-1475 | Linear Prediction does not work in the 8.1.0 release | NeuralTools |
| DTS-1499 | Number of Trials in the Summary Report is always zero | NeuralTools |
Release 8.1 - November, 2020
Highlights
All Products: Spanish Translation
The user interface for all the version 8.0 add-ins in the DecisionTools Suite have been translated into Spanish.
While the user interface and example files have all be localized into Spanish, unfortunately the Spanish product documentation was not completed as of the release date. Only the Evolver, PrecisionTree, and NeuralTools documentation is available in this release. If you are using @RISK’s online help system, the product will automatically start delivering Spanish documentation content as soon as it becomes available. If you are using the local help system of @RISK or the other products, you will need to update your software to get the translated documentation.
@RISK: Disable All Correlations During Simulations
There is a new Simulation Setting on the Sampling Tab (Figure 5, below) to disable all the correlations defined in your model. A shortcut for this setting can also be found in the Correlation Menu (Figure 6, below).
Figure 5 - Sampling Settings
Figure 6 - Correlation Menu
@RISK: Identify and Graph Outliers in Box Plots
Box Plots on the Summary Window or Data Viewer Window can now display outliers. This can be customized for an individual graph from the Graph Options dialog, or for all graphs from within @RISK’s Graphing Preferences dialog.
@RISK: Calculate Joint Probabilities Using New Statistic Functions
Two new @RISK statistic formulas allow you to calculate joint probabilities for two or more simulated input or outputs.
-
RiskJointProb2Dim calculates the fraction of iterations where a two simulated outputs or inputs fall in a given quadrant. (This matches the results shown by the delimiters in an @RISK scatter graph.)
-
RiskJointProbMultiDim calculates the fraction of iterations where any number of outputs or inputs meet a given set of range conditions.
@RISK: Select Report Outputs and Inputs across Multiple Worksheets
This new feature allows you to select multiple Excel ranges from different worksheets in the same workbook (Figure 7, below). You can also delete specific ranges, or change the order of how they will be displayed in your report.
Figure 7 - Output Report Configuration
@RISK: Choose and Order Results in Summary Graphs
The Summary Trend and Box Plot graphs now have a Summary Graph Manager that allows you to add, remove, and order the inputs and outputs shown in the graph. You can find it in the Settings/Actions menu of the Summary Graph Window.
@RISK: Model List Status Column Helps Identify Locked Inputs
The Model List Window (Figure 8, below) and Results Summary Window (Figure 9, below) now include a status column to visually show when an input is locked. From the Model List, you can lock and unlock inputs from the Edit menu or right-click context menu.
Figure 8 - Model List with Locked Inputs
Figure 9 - Results Summary with Locked Inputs
@RISK: Configure Two-Color Tornados
The Change in Output Statistic Tornado now allows the customization the two colors of the bars, so you can better differentiate between high and low inputs. The colors can be controlled for an individual graph using the Graph Options dialog. To control the colors for all new graphs, go to the Graphing Preferences dialog.
RiskOptimizer Graph to Compare Original vs Optimized Distribution
The Browse Results Window now allows you to compare the original distribution to the optimized distribution found by RISKOptimizer.
@RISK: New Dynamic Welcome Screen Content
Find the latest news from Palisade and @RISK in the new dynamic Welcome Screen. If you prefer to disable the Welcome Screen at startup, we’ll put notifications on the @RISK menu whenever there is new content available.
@RISK: Increased Report Limits
Summary and Detailed Statistics report tables can now include up to 500 inputs or outputs.
@RISK: New Goal Seek User Interface
The @RISK Goal Seek feature has been updated with an improved user interface and experience.
@RISK: Better Display Scaling
This version of @RISK has improved handling of different display scales (also known as DPI scales) in its windows, graphs, and reports.
@RISK: Add Property Functions from the Insert Menu
The ability to add Property Functions to your @RISK functions using the Insert Menu has been restored to @RISK version 8.
@RISK: Reference Overlays on Non-Active Sheets in the Define Distribution Window.
The option to overlay a distribution from an Excel range in the Define Distribution Window now supports selecting Excel cells from a non-active sheet.
NeuralTools: New Classification Performance Measures Report
For binary classification problems, one of the values in the dependent variable can now be defined as the “Positive Category”. With this designation we can present the testing results in terms of True/False Positives or Negatives; as well as reporting Accuracy, Precision, Recall, and F1 Score for the neural net’s performance.
Enhancements
| DTS-63 | Choose and Order Results in Summary Graphs | @RISK |
| DTS-64 | Reference Overlays on Non-Active Sheets in the Define Distribution Window | @RISK |
| DTS-142 | Better Display Scaling | @RISK |
| DTS-201 | Added statistic table options to Graphing Preferences dialog | @RISK |
| DTS-302 | Identify and Graph Outliers in Box Plots | @RISK |
| DTS-377 | Disable All Correlations During Simulations | @RISK |
| DTS-383 | Configure Two-Color Tornados | @RISK |
| DTS-400 | RiskOptimizer Graph to Compare Original vs Optimized Distribution | @RISK |
| DTS-401 | Calculate Joint Probabilities Using New Statistic Functions | @RISK |
| DTS-411 | Add appropriate error messages when attempting to correlate uncorrelatable functions | @RISK |
| DTS-471 | Increased Report Limits | @RISK |
| DTS-481 | Add Property Functions from the Insert Menu | @RISK |
| DTS-499 | Improved handling of manually deleted correlation matrices and copulas | @RISK |
| DTS-512 | Support for worksheet-level correlation names | @RISK |
| DTS-606 | Restore Insert Property Function Menu to be part of the Ribbon options | @RISK |
| DTS-607 | Enabled Multiple reports dialog configuration for models without simulation results | @RISK |
| DTS-730 | Select Report Outputs and Inputs across Multiple Worksheets | @RISK |
| DTS-788 | New Dynamic Welcome Screen Content | @RISK |
| DTS-974 | Allow loading values from Excel range directly into Percentile Defaults Dialog | @RISK |
| DTS-1439 | Model List and Results Summary Status Column Helps Identify Locked Inputs | @RISK |
| DTS-720 | Simplified activation process to only offer manual activation after automatic activation failure | Licensing |
| DTS-381 | New Classification Performance Measures Report | NeuralTools |
Fixes
| DTS-11 | Negative values are not shown correctly in sensitivity report table | @RISK |
| DTS-12 | Incorrect column headers in "Overlay Simulations" report table | @RISK |
| DTS-13 | Incorrect table values shown in sensitivity report | @RISK |
| DTS-17 | Copying worksheets between two workbooks containing correlations with the same name can confuse @RISK | @RISK |
| DTS-18 | Fit Manager blocks adding fit to non-active workbook | @RISK |
| DTS-21 | Scenario Setttings not properly handling -Infinity as a lower bound | @RISK |
| DTS-23 | XDK Sensitivity Report sometimes showing incorrect table | @RISK |
| DTS-90 | Compact Output Report does not fit on one Excel page | @RISK |
| DTS-91 | PDF Reports not showing Chinese characters | @RISK |
| DTS-92 | Report worksheets can have naming conflicts | @RISK |
| DTS-118 | Incorrect worksheet names for some scenario reports | @RISK |
| DTS-133 | Bad Summary Statistics and Detailed Statistics report titles when using multiple named simulations | @RISK |
| DTS-144 | Saving a scenario setting as defaullt that doesn't use percentiles doesn't work correctly | @RISK |
| DTS-189 | Incorrect filter minimum and maximum shown in detailed statistics report | @RISK |
| DTS-267 | Report graph images can sometimes be blurry | @RISK |
| DTS-350 | Remove @RISK Functions does not display a warning message when trying to remove functions from a protected workbook | @RISK |
| DTS-372 | Error after deleting columns with correlation matrix | @RISK |
| DTS-412 | Swapping in @RISK function with Excel in manual recalculation mode shows #NAME? errors | @RISK |
| DTS-421 | RISKOptimizer sometimes sends reports to the wrong workbook | @RISK |
| DTS-422 | Mouse wheel no longer works when RISKOptimizer reports are sent to Active Workbook | @RISK |
| DTS-467 | Recently simulated file links in Welcome Screen do not work if files are saved in OneDrive | @RISK |
| DTS-469 | Error clicking in empty header column in Copula Fit Results window | @RISK |
| DTS-493 | Error inside Model dialog after deleting correlation matrices | @RISK |
| DTS-624 | Compact output report delimiter values do not match Left X and Right X summary statistics values | @RISK |
| DTS-634 | Sensitivity Report with Regression Mapped Values uses incorrect number formatting | @RISK |
| DTS-647 | Non US-English regional settings causing RiskCompound issues | @RISK |
| DTS-659 | Opening models that prompt to update links sometimes interfere with loading saved simulation settings | @RISK |
| DTS-660 | Error simulating RiskSplice distributions that have internal distributions that use the implicit intersection '@' symbol | @RISK |
| DTS-695 | Define distribution overlay reference is not updated when referencing a distribution in another cell | @RISK |
| DTS-696 | Define Distribution Window distribution panel scrolled incorrectly after exiting Free-Edit mode | @RISK |
| DTS-711 | Overflow error when changing alt parameterization in Define Distribution Window | @RISK |
| DTS-768 | Added support for date variables to summary graphs | @RISK |
| DTS-769 | Allow summary graphs to be created with a single variable | @RISK |
| DTS-783 | Graph options dialog sometimes not displayed after showing the Excel cells selector | @RISK |
| DTS-792 | Distribution Artist: Remove Bar is missing from the right-click menu | @RISK |
| DTS-798 | Output Range: When copy pasting the name of an individual ouput the information from the entire row is copied and pasted |
@RISK |
| DTS-811 | Specific large model either runs very slowly with Multiple CPUs | @RISK |
| DTS-818 | In Sensitivity Settings Dialog, removing selection for Must Change Statistic By doesn't update graph | @RISK |
| DTS-905 | Summary Trend and Summary Box Plot graphs do not retain currency formatting of inputs/outputs | @RISK |
| DTS-918 | External function calls inside RiskName field can cause crashes when opening a model | @RISK |
| DTS-975 | Error with Spanish regional settings and output with name defined using a disjoint range | @RISK |
| DTS-976 | Large customer model runs slowly with Multiple CPUs | @RISK |
| DTS-979 | Pressing the Esc-key while the mouse is down on window's title bar can cause VBA code execution to be interrupted | @RISK |
| DTS-1026 | Graphing Preferences Dialog BoxPlot tab has incorrect statistics names | @RISK |
| DTS-1063 | RiskLock doesn't return proper static value for Time Series functions | @RISK |
| DTS-1064 | Dragging and dropping between two Browse Result Windows can result in two curves showing the same output | @RISK |
| DTS-1065 | Copying and pasting sometimes works incorrectly inside the Define Correlation Dialog | @RISK |
| DTS-1067 | Linked fit that references a function name instead of a fit statistic fails | @RISK |
| DTS-1068 | Copying and pasting sometimes works incorrectly inside the Define Filters Dialog | @RISK |
| DTS-1069 | Copying and pasting sometimes works incorrectly inside the Scenario Settings Dialog | @RISK |
| DTS-1143 | Data Window display issues for large models | @RISK |
| DTS-1256 | Data Window's Iteration Step function crashes Excel with particular model | @RISK |
| DTS-1296 | Customer model cannot be Swapped in, message saying a formula couldn't be correctly parsed | @RISK |
| DTS-1305 | Improper license expiration messages from licenses borrowed from a network server | @RISK |
| DTS-1328 | Error message trying to edit a correlation matrix through Model Window | @RISK |
| DTS-1329 | Local help for some dialogs forced behind Excel window | @RISK |
| DTS-1360 | Iteration filter applied to statistic function causes crash if statistic functions update every iteration | DTools;@RISK |
| DTS-1083 | Diagnostic Utility is checking for incorrect VC++ runtimes | Installer / Deployment |
| DTS-1347 | Repairing a license doesn't refresh the Server Manager window | Licensing |
| DTS-349 | Training large customer file leads to 'Application-defined or object-defined error" | NeuralTools |
| DTS-531 | Right-click option to select or deselect all variables in the Data Viewer is not working | NeuralTools |
| DTS-993 | Right-click context menu shows also with left click in Dataset Manager Dialog | NeuralTools |
| DTS-536 | "Invalid formula" message trying to simulate PrecisionTree influence diagram in @RISK | PrecisionTree |
| DTS-786 | Influence Diagram calculation ordering problems | PrecisionTree |
| DTS-1362 | @RISK Reports sent to Excel do not include graphs when PrecisionTree is also open. | PrecisionTree |
| DTS-656 | Problems with Pareto Charts with large number of cateogories | StatTools |
| DTS-725 | Same variable can be selected as Cat and Val for Pareto Charts | StatTools |
| DTS-1071 | Inputs defined with RiskName don't display names correctly in tornado charts and spider graphs | TopRank |
Release 8.0.1 - July, 2020
Highlights
All Products: Dynamic Array Support
Some versions of Office 365 now include support for a new type of array formulas known as “dynamic arrays”. This resulted in changes to the syntax of some other non-array formulas: users will notice the “@” sign in some formulas, where it did not appear before. While TopRank itself does not make use of dynamic arrays, it has its own custom cell functions, and their syntax was affected by the introduction of dynamic arrays. This version has been made compatible with the new syntax.
PrecisionTree: Link to BigPicture Removed
The BigPicture add-in has been discontinued. The “View in BigPicture” ribbon command has been removed in this version.
TopRank: Running TopRank and @RISK at the Same Time
Previous versions of TopRank would sometimes require special reconfiguration of @RISK so the two add-ins could both be loaded at the same time. This requirement has been removed in this version.
Enhancements
| DTS-370 | Implemented ability to right-click on tornado bar to hide it | @RISK |
| DTS-409 | Minor formatting change in group separator rows in Detailed Statistics Report | @RISK |
| DTS-433 | Graph View of Correlation Definition Window displays coefficients for each cell | @RISK |
Fixes
| DTS-420 | Repair button improperly enabled for broken and expired licenses in Palisade Server Manager | Licensing |
| DTS-364 | Some permanent licenses incorrectly marked as expiring in Palisade Server Manager | Licensing |
| DTS-127 | Clicking on parameter label in Define Distribution Window leads to error | @RISK |
| DTS-191 | Right click on Category row in Results Summary window generates error message | @RISK |
| DTS-199 | Export to Excel from Data Window when Iterations is set to Auto generates 'Unable to generate report' error | @RISK |
| DTS-236 | Auto Save notification links to incorrect help page. | @RISK |
| DTS-242 | Graph font size problems with large monitors with large DPI scaling | @RISK |
| DTS-262 | Incorrect Filter Minimum and Maximum shown in Detailed Statistics Report | @RISK |
| DTS-263 | Sensitivity Report shows incorrect sensitivity calculation table in some situations | @RISK |
| DTS-264 | Compact Output report to Excel does not fit on one page | @RISK |
| DTS-265 | Incorrect Tornado bar labels for inputs containing RiskName property function that use cell references across multiple worksheets | @RISK |
| DTS-273 | Browse Results window too wide at 200% DPI scaling | @RISK |
| DTS-296 | Dragging graphs from Multivariate Data Viewer sometimes triggers error | @RISK |
| DTS-322 | Exports from the Data Window of very large data sets can generate 'Unable to copy cells.' error. | @RISK |
| DTS-347 | Knowlege Base item on the Resource menu links to incorrect web page | @RISK |
| DTS-438 | Deleted Predefined Distribution still shows on the Define Distribution Favorites list | @RISK |
| DTS-474 | File with copula information fails to open | @RISK |
| DTS-511 | Problems opening Define Correlation dialogs with inputs across multiple workbooks | @RISK |
| DTS-535 | Problem when two workbooks have correlation matrices with the same name | @RISK |
| DTS-621 | Bar Shading in Change in Output Tornado Graphs May Be Reversed | @RISK |
| DTS-623 | RiskName with multiple cells references for Alt distributions can cause errors | @RISK |
| DTS-624 | Compact output report delimiter values do not match Left X and Right X summary statistics values | @RISK |
| DTS-75 | Performing multiple exports from the Results Summary Window can cause Excel to close unexpectedly | @RISK |
| DTS-456 | Application Settings dropdown menu options can not be selected using mouse | TopRank |
